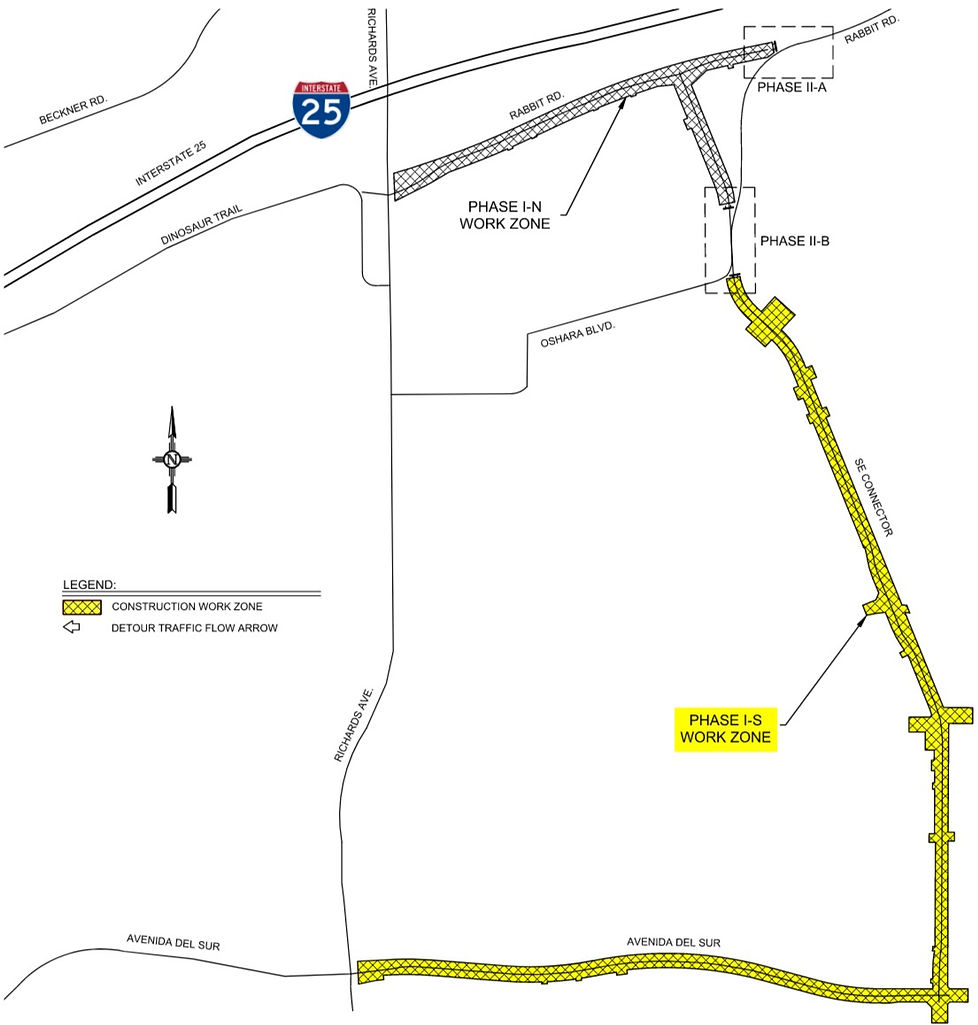

Phase I-N
Phase I-N

Phase I-N

Schedule:
Mid-February, through Mid-June, 2023

Description:
Construction of the new, offline, portions of Rabbit Road and SE Connector between Oshara Boulevard and Rabbit Road

Route Impacts:

  • No closures are anticipated.

  • Construction related traffic will be using area roads to access various portions of the site.

Overlap:
Phase I-S

Phase I-S

Phase I-S

Schedule:
Mid-February, through late January, 2024

Description:
Construction of the new, offline, portions of Rabbit Road and SE Connector south of Oshara Boulevard and Avenida del Sur east of the Richards Avenue intersection.

Route Impacts:

  • No closures are anticipated.

  • Construction related traffic will be using area roads to access various portions of the site.

Overlap:
All Phases

Phase IV

Phase IV

Schedule:
Mid-May, through mid-July, 2023

Description:
Reconstruction of Avenida del Sur and Richards Avenue intersection.

Overlap:
Phase I-N and I-S,

Route Impacts:

  • Closure of the Avenida del Sur and Richards Avenue Intersection.

  • Construction related traffic will be using area roads to access various portions of the site.

Phase I-A

Phase I-A

Schedule:
Mid-July, through mid-September, 2023

Description:

Reconstruction of Dinosaur Trail/Rabbit Road and Richards Avenue intersection.

Overlap:
Phases I-S

Route Impacts:

  • Richards Avenue Closed between Beckner Road and Dinosaur Trail. The existing Dinosaur Trail and Richards Avenue intersection provided access to Richards Avenue south of Dinosaur Trail.

  • Construction related traffic will be using area roads to access various portions of the site.

Phase II-A

Phase II-A

Schedule:
Mid-September, through early October, 2023

Description:
Construction of the Oshara Boulevard and SE Connectors intersection.

Route Impacts:

  • Closure of existing Rabbit Road to Oshara Boulevard connection.

  • Construction related traffic will be using area roads to access various portions of the site.

Overlap:
Phases I-S

Phase II-B

Phase II-B

Schedule:
Early October, through mid-December, 2023

Description:
Construction of the Oshara Boulevard and SE Connectors intersection.

Overlap:
Phase I-S

Route Impacts:

  • Closure of existing Rabbit Road to Oshara Boulevard connection.

  • Construction related traffic will be using area roads to access various portions of the site.

Phase III

Phase III

Route Impacts:

  • Closure of Dinosaur Trail west of Richards Avenue.

  • Construction related traffic will be using area roads to access various portions of the site.

Schedule:
Mid-December, through late January, 2024

Description:

Construction of connection between the existing and proposed Dinosaur Trail segments.

Overlap:
Phase I-S
